Industrial machinery setup featuring piping, control panels, and H.F.O. heaters in a facility.

Fast Pace Turnkey Solution for Nordana

RayClean™ on Board the M/V Brattingsborg

DESMI Ocean Guard demonstrated great agility and pace as a loose component project with the shipowner, Nordana, evolved into a full turnkey solution delivered and commissioned in just four months - from first inspection to final commissioning.



From September 2015 to January 2016, DESMI Ocean Guard prepared and installed a RayClean™ 300 system along with a wide range of associated components under time pressure and difficult circumstances.



The turnkey solution involved a thorough ship inspection in Italy, 3D scanning in Norway, engineering, manufacturing, and installation of the tailored components, class approval, delivery and installation of loose components in China, and handover in Singapore. This project quickly evolved and when the need for flexibility emerged, DESMI Ocean Guard managed to beat the usual production time.

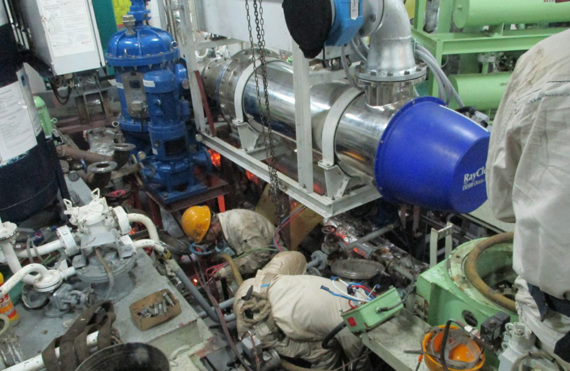

Workers installing machinery in an industrial setting with various pipes and equipment.

RayClean™ on Board the M/V Brattingsborg

The RayClean™ solution was installed on board the M/V Brattingsborg

Main components in the project:

• B & K backflush filter
• Master control panel
• UV control panel
• UV unit
• Stripping pump
• Backflush pump
• Valves
• Flow meter

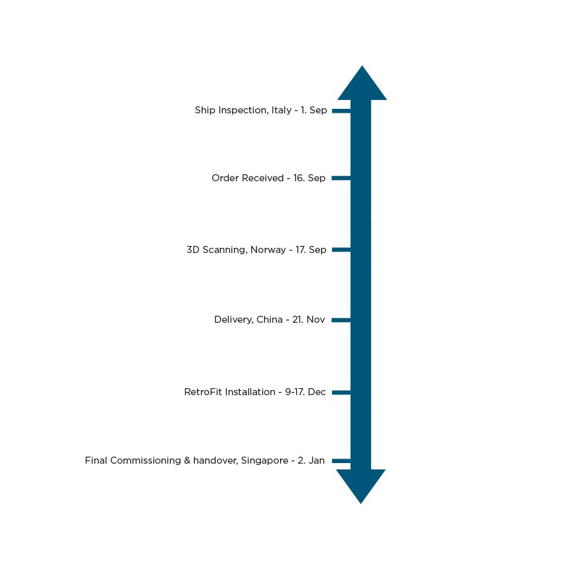

Project timeline with key events from September to January, ending in Singapore.

Unrivalled treatment performance and lowest energy consumption in class.

RayClean™ Ballast Water Management System

RayClean™ has no salinity or temperature limitations and has been proven effective in water with UV-T (UV-Transmission) as low as 0.33, which sets the industry benchmark!

Industrial fluid handling equipment with metallic cylinders and blue end caps.

WE ASSIST YOU FROM CONTACT TO COMPLIANCE

WE OFFER OUR SERVICES THROUGHOUT THE PROJECT

We strive to accommodate the needs of our customers in every way possible. Besides our products we also offer complete engineering including ship inspections, 3D laser scanning, preparation of drawings, class approval, prefabrication of piping, installation and commissioning.
